Utility-scale Network Batteries

Share Utility-scale Network Batteries on Facebook Share Utility-scale Network Batteries on Twitter Share Utility-scale Network Batteries on Linkedin Email Utility-scale Network Batteries link

Our Local Network Battery Plan is building utility-scale batteries, connected to the High Voltage electricity distribution network across Queensland, for cleaner power.

The success of stage one of the plan, led to us installing these large batteries in more communities to support the continuing uptake of renewable energy. Which is now seeing further batteries installed across the state.

Each energy storage system is a large 4MW/8MWh battery (see image above). They are allowing more solar energy to be sent back into the grid, while the suns shining, storing it for use locally when electricity demand is high.

How will the batteries work?

The utility-scale battery are connected into the local electricity network. They soak up the excess solar energy generated during the day from the local rooftop solar energy systems. Then, when the sun goes down, the stored energy is released back into the network for use during the evening peak when demand is high.

Where are the batteries being located?

The batteries that have been installed can be seen in the linked map. You can read about them in the Community Updates.

Our Local Network Battery Plan will see more than 50 batteries across Queensland to store more than 400MWh of solar everyday.

Where are we up to in our installations?

Below is a table providing a snapshot of our battery projects across the state, showing the location of the site along with the progress at each site.

Stage 3
Location
Latest Update from siteSite image

Agnes Water

  • Early works complete.
  • Civil construction August 2025 to end 2025.
  • Battery expected to be installed and energised late 2026.

Clinton
  • Early works underway.
  • Civil construction expected mid to late 2025.
  • Battery expected to be installed and energised by mid 2026.

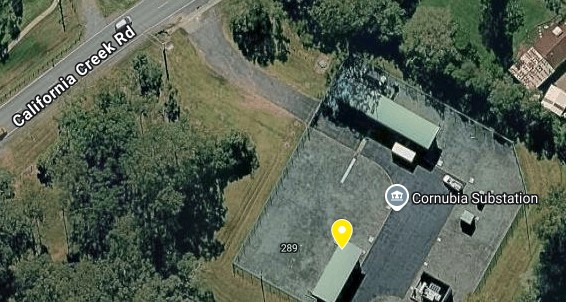

Cornubia
  • Early works completed.
  • Civil construction commenced.
  • Battery expected to be installed and energised by mid 2026.

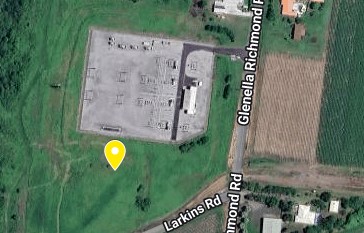

Glenella
  • Early works commenced.
  • Civil construction to be completed by end 2025.
  • Battery expected to be installed and energised by mid 2026.

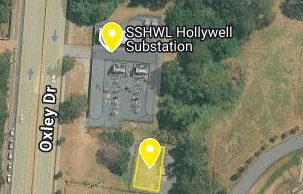

Hollywell
  • Early works commenced.

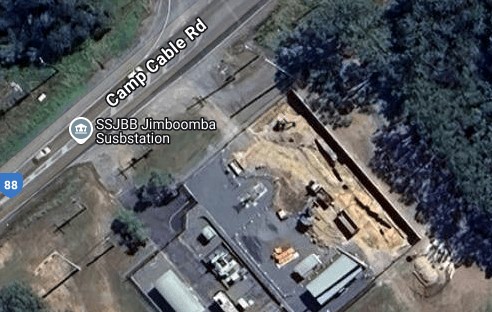

Jimboomba
  • Early works commenced.
  • Battery expected to be installed and energised late 2025 to early 2026.

Toowoomba (Kearneys Spring)

  • Civil construction complete.
  • Battery expected to be installed and energised late 2025.
  • Image - Civil works in progress January 2025

Millchester
  • Early works underway.
  • Civil construction expected to be completed by end 2026.
  • Battery expected to be installed and energised mid to late 2026.

Mooloolaba

  • Early works completed.
  • Battery expected to be installed and energised late 2025 to early 2026.
  • Image - Site prepared ready for battery March 2025.

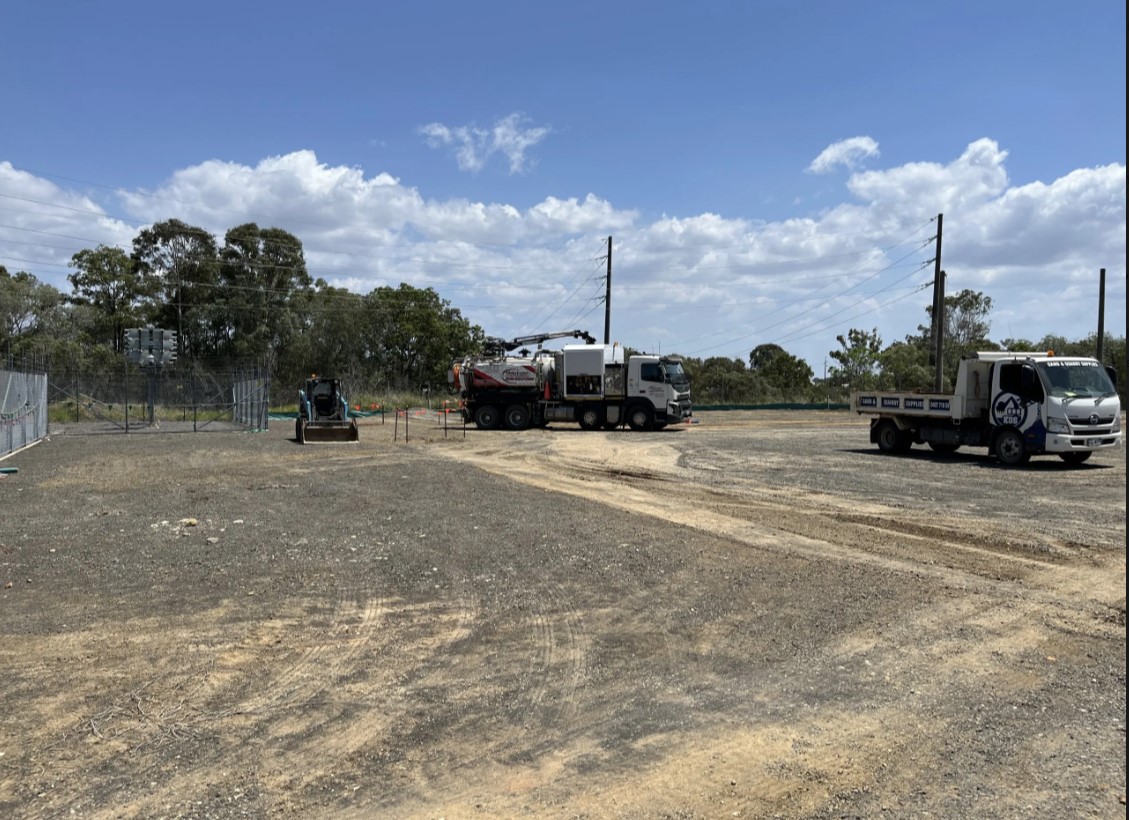

Maryborough
  • Early works completed.
  • Civil construction complete.
  • Battery expected to be installed and energised by late 2025.
Woodridge
  • Early works completed.
  • Civil construction works complete.
  • Battery expected to be installed and energised early to mid 2026.

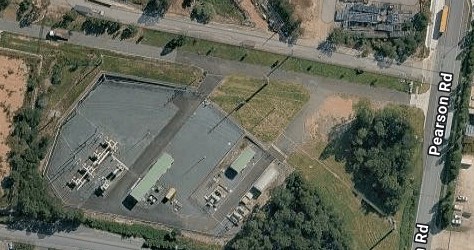

Yatala
  • Early works completed.
  • Civil construction commenced.
  • Battery expected to be installed and energised by mid 2026.

Stage 2
Location
Latest Update from SiteSite image

Bribie Island

  • Construction complete.
  • Commissioning in progress.

Image coming soon

Emerald
  • Construction complete.
  • Commissioning in progress.
Gladstone South

  • Construction complete.
  • Commissioning in progress.

Image coming soon

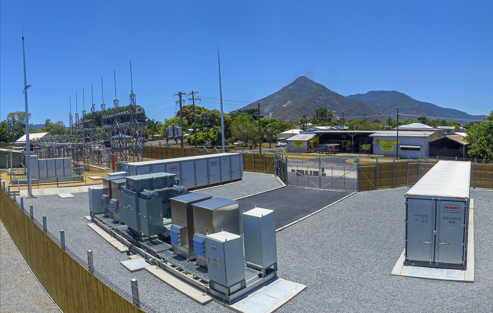

Gordonvale

  • Construction complete.
  • Commissioning in progress.

Howard
  • Construction complete.
  • Commissioning in progress.

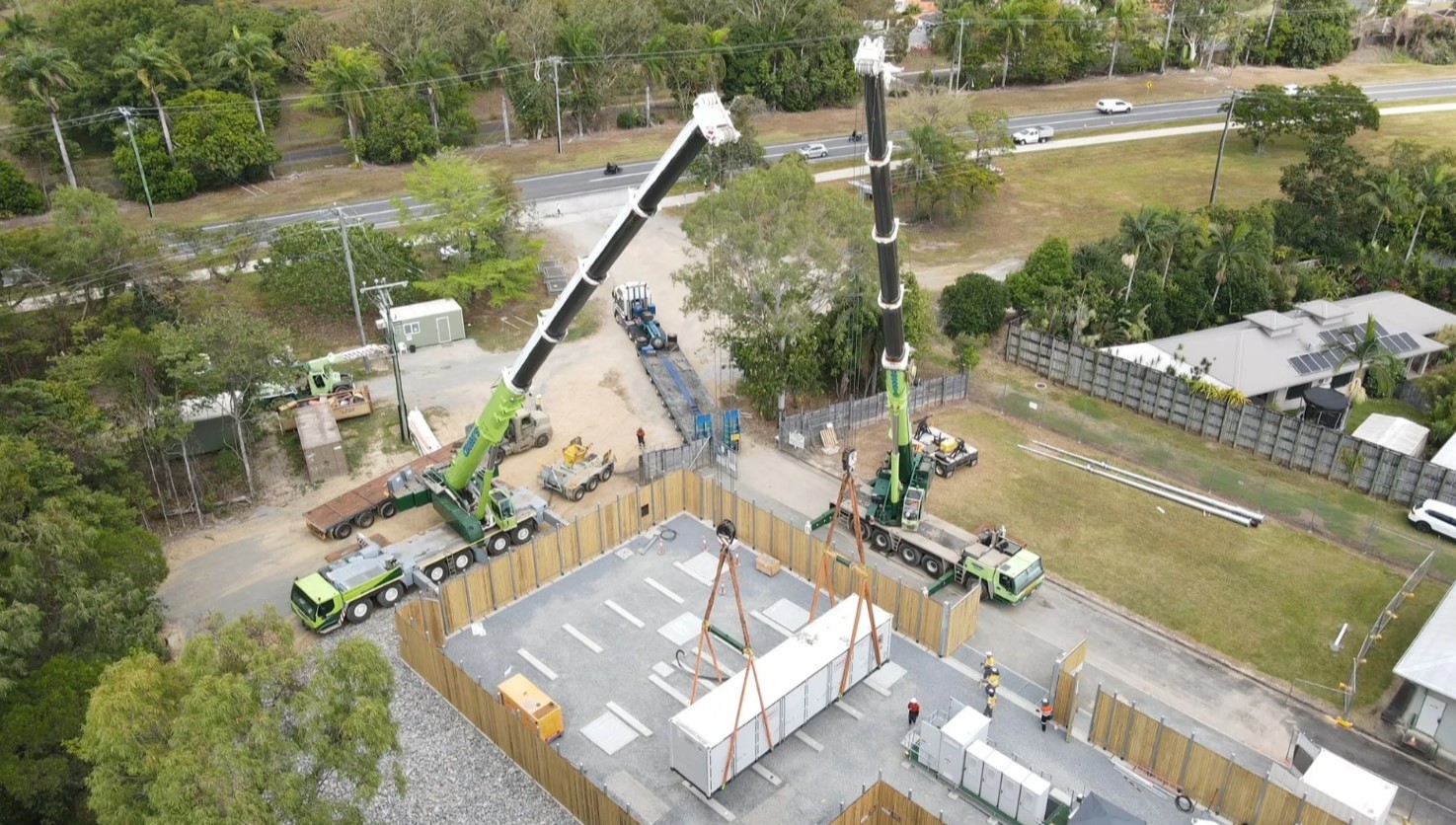

Kewarra Beach

  • Construction complete.
  • Commissioning in progress.

Marian South
  • Construction complete.
  • Commissioning in progress.

Morayfield

  • Construction complete.
  • Commissioning in progress.

Mundubbera
  • Construction complete.
  • Commissioning in progress.

Raby Bay
  • Construction complete.
  • Commissioning in progress.

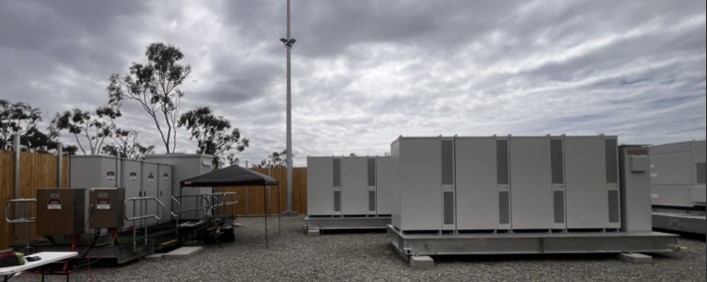

Townsville (Rasmussen)
  • Construction complete.
  • Commissioning in progress.

Torrington
  • Construction complete.
  • Commissioning in progress.

Stage 1
Location
Latest Update from siteSite Image

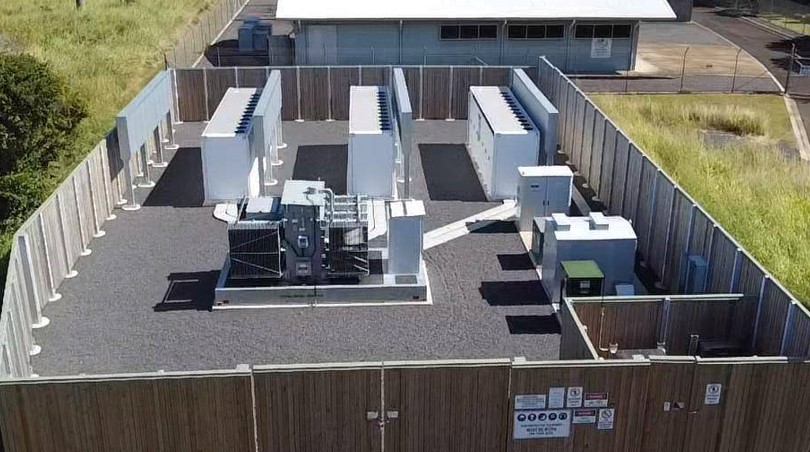

Bundaberg
(Bargara)
  • Construction complete.
  • Battery installed May 2023.

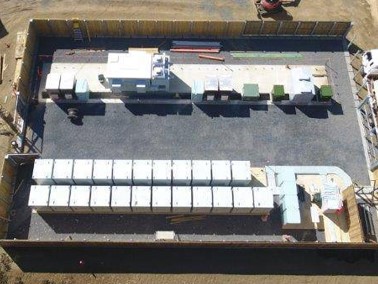

Hervey Bay (Torquay)
  • Construction complete.
  • Battery installed February 2025.

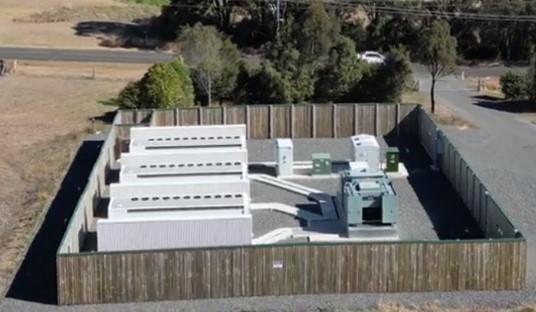

Toowoomba (Kleinton)
  • Construction complete.
  • Battery installed March 2023.

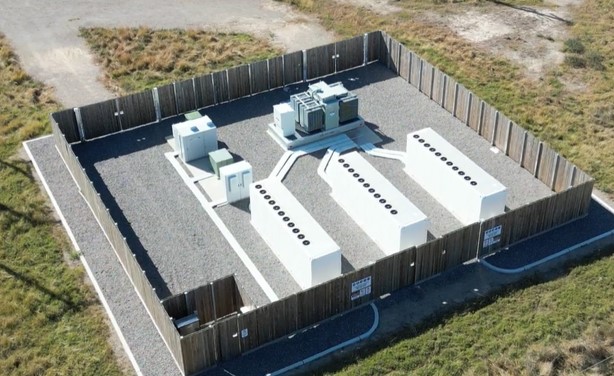

Townsville
(Black River)
  • Construction complete.
  • Battery installed September 2023.

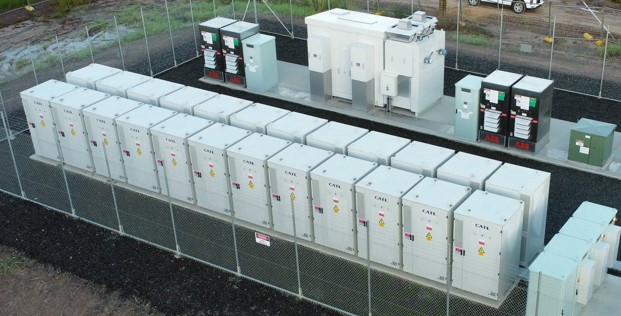

Yeppoon
(Tanby)
  • Construction complete.
  • Battery installed December 2024.

Trial
Location
Latest Update from site
Site Image

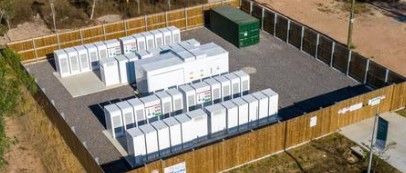

Townsville
(Bohle)

  • Civil construction complete.

Want to know more?

This is just one of the ways Energy Queensland is enabling the transition to a renewable energy future and, ultimately, helping to keep electricity prices down.

You can read more about our Local Network Battery Plan, and how batteries are becoming an essential tool for managing the renewable energy flowing into Queensland’s electricity networks.

We are also trialling neighbourhood batteries and piloting community batteries on the Low Voltage electricity network.

You can also take a look at these frequently asked questions about our battery program.

Or pop us a note in the QUESTIONS-FEEDBACK tab below.

Our Local Network Battery Plan is building utility-scale batteries, connected to the High Voltage electricity distribution network across Queensland, for cleaner power.

The success of stage one of the plan, led to us installing these large batteries in more communities to support the continuing uptake of renewable energy. Which is now seeing further batteries installed across the state.

Each energy storage system is a large 4MW/8MWh battery (see image above). They are allowing more solar energy to be sent back into the grid, while the suns shining, storing it for use locally when electricity demand is high.

How will the batteries work?

The utility-scale battery are connected into the local electricity network. They soak up the excess solar energy generated during the day from the local rooftop solar energy systems. Then, when the sun goes down, the stored energy is released back into the network for use during the evening peak when demand is high.

Where are the batteries being located?

The batteries that have been installed can be seen in the linked map. You can read about them in the Community Updates.

Our Local Network Battery Plan will see more than 50 batteries across Queensland to store more than 400MWh of solar everyday.

Where are we up to in our installations?

Below is a table providing a snapshot of our battery projects across the state, showing the location of the site along with the progress at each site.

Stage 3
Location
Latest Update from siteSite image

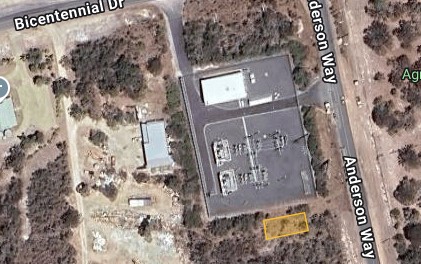

Agnes Water

  • Early works complete.
  • Civil construction August 2025 to end 2025.
  • Battery expected to be installed and energised late 2026.

Clinton
  • Early works underway.
  • Civil construction expected mid to late 2025.
  • Battery expected to be installed and energised by mid 2026.

Cornubia
  • Early works completed.
  • Civil construction commenced.
  • Battery expected to be installed and energised by mid 2026.

Glenella
  • Early works commenced.
  • Civil construction to be completed by end 2025.
  • Battery expected to be installed and energised by mid 2026.

Hollywell
  • Early works commenced.
Jimboomba
  • Early works commenced.
  • Battery expected to be installed and energised late 2025 to early 2026.

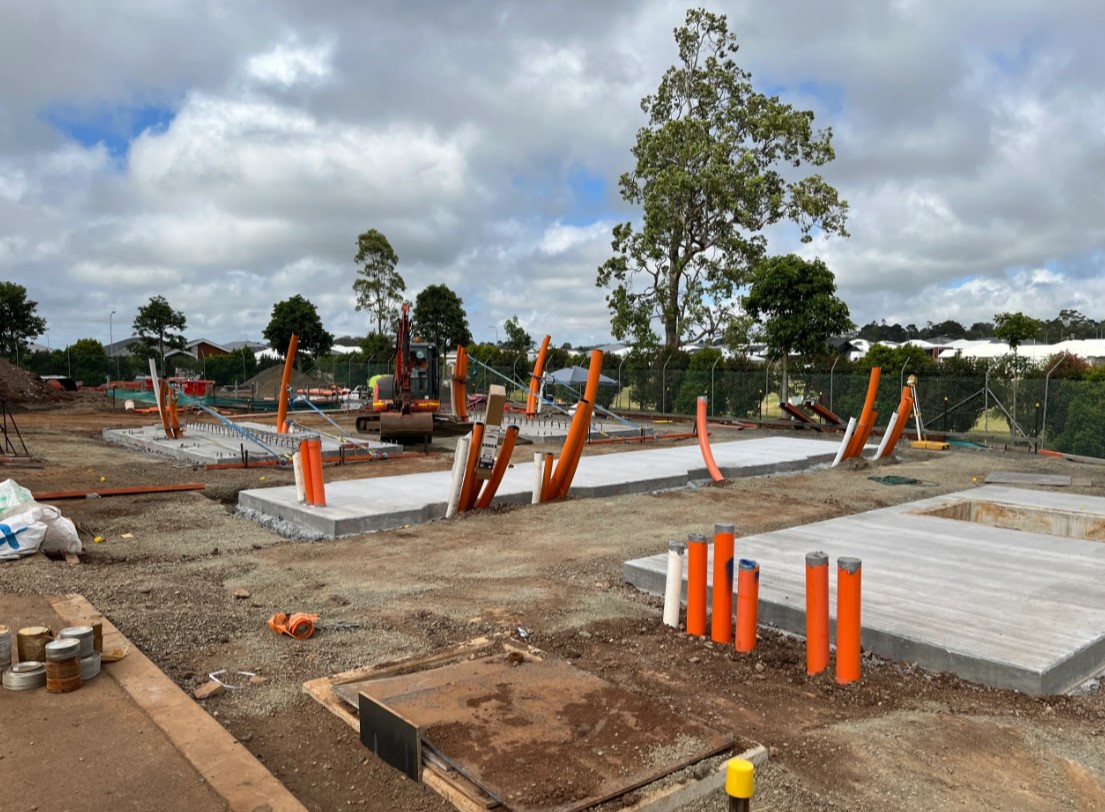

Toowoomba (Kearneys Spring)

  • Civil construction complete.
  • Battery expected to be installed and energised late 2025.
  • Image - Civil works in progress January 2025

Millchester

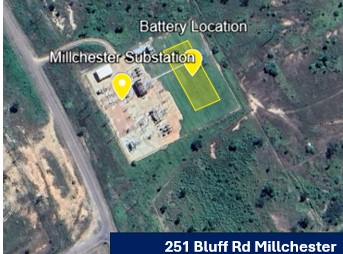

  • Early works underway.
  • Civil construction expected to be completed by end 2026.
  • Battery expected to be installed and energised mid to late 2026.

Mooloolaba

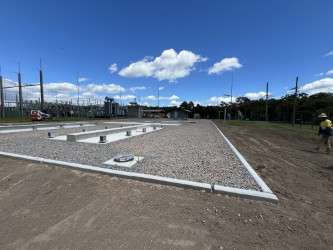

  • Early works completed.
  • Battery expected to be installed and energised late 2025 to early 2026.
  • Image - Site prepared ready for battery March 2025.
Maryborough
  • Early works completed.
  • Civil construction complete.
  • Battery expected to be installed and energised by late 2025.
Woodridge

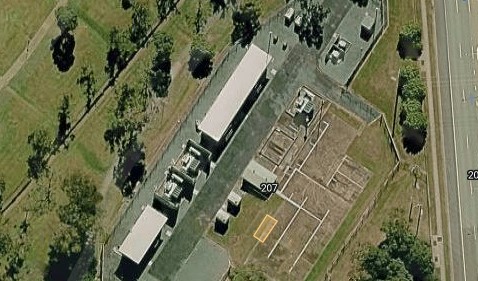

  • Early works completed.
  • Civil construction works complete.
  • Battery expected to be installed and energised early to mid 2026.
Yatala
  • Early works completed.
  • Civil construction commenced.
  • Battery expected to be installed and energised by mid 2026.

Stage 2
Location
Latest Update from SiteSite image

Bribie Island

  • Construction complete.
  • Commissioning in progress.

Image coming soon

Emerald
  • Construction complete.
  • Commissioning in progress.
Gladstone South

  • Construction complete.
  • Commissioning in progress.

Image coming soon

Gordonvale

  • Construction complete.
  • Commissioning in progress.

Howard
  • Construction complete.
  • Commissioning in progress.

Kewarra Beach

  • Construction complete.
  • Commissioning in progress.

Marian South
  • Construction complete.
  • Commissioning in progress.

Morayfield

  • Construction complete.
  • Commissioning in progress.

Mundubbera
  • Construction complete.
  • Commissioning in progress.

Raby Bay
  • Construction complete.
  • Commissioning in progress.

Townsville (Rasmussen)
  • Construction complete.
  • Commissioning in progress.

Torrington
  • Construction complete.
  • Commissioning in progress.

Stage 1
Location
Latest Update from siteSite Image
Bundaberg
(Bargara)
  • Construction complete.
  • Battery installed May 2023.

Hervey Bay (Torquay)
  • Construction complete.
  • Battery installed February 2025.

Toowoomba (Kleinton)
  • Construction complete.
  • Battery installed March 2023.

Townsville
(Black River)
  • Construction complete.
  • Battery installed September 2023.

Yeppoon
(Tanby)
  • Construction complete.
  • Battery installed December 2024.

Trial
Location
Latest Update from site
Site Image
Townsville
(Bohle)

  • Civil construction complete.

Want to know more?

This is just one of the ways Energy Queensland is enabling the transition to a renewable energy future and, ultimately, helping to keep electricity prices down.

You can read more about our Local Network Battery Plan, and how batteries are becoming an essential tool for managing the renewable energy flowing into Queensland’s electricity networks.

We are also trialling neighbourhood batteries and piloting community batteries on the Low Voltage electricity network.

You can also take a look at these frequently asked questions about our battery program.

Or pop us a note in the QUESTIONS-FEEDBACK tab below.

Ask a question or provide feedback about the Battery Plan here.
